West Avenue Phase II Project Update 5/29/26

Dear Residents,

 We hope this message finds you well. We’d like to share a few important upcoming operations that residents should be aware of over the next few weeks:

  • Sanitary sewer installation on 16 Street will continue over the next couple of weeks. The sewer pipe installation is proceeding in phases, and each phase includes multiple private property connections. The project team will notify affected properties as schedules and impacts are confirmed.

Two-Week Look Ahead Schedule
You can view the contractor's full current schedule anytime under the “Two-Week Look Aheads” tab on the City’s project page: West Avenue Project Page. It outlines ongoing and upcoming construction activities, including where crews are expected to be working and what type of work will be performed.

We've summarized the information to include the anticipated work in Segments 1, 2 and 3 through June 14, 2026 below.

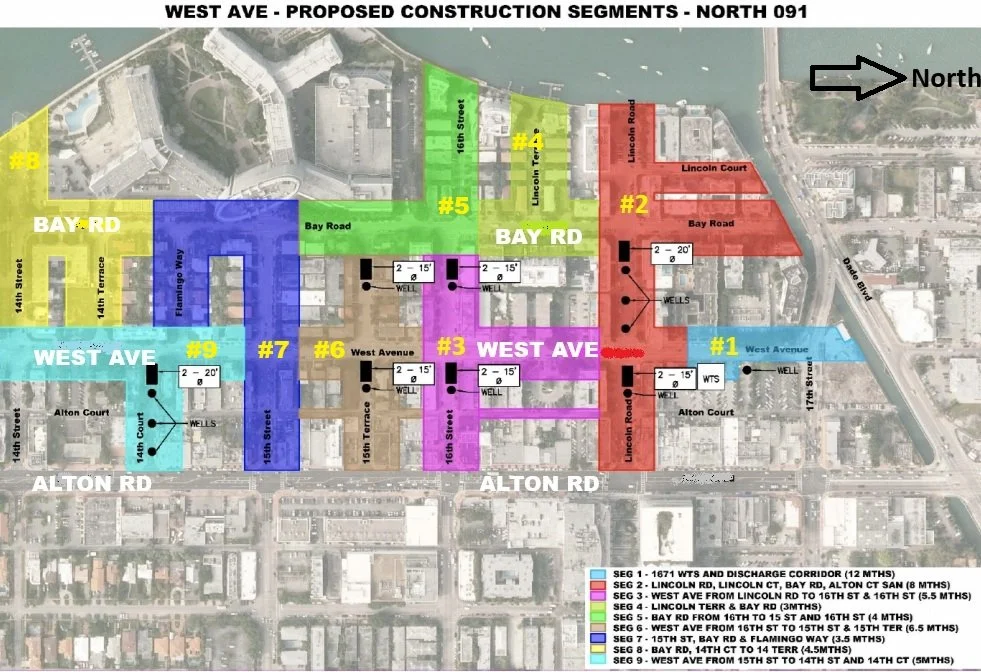

Segment 1 (Pump Station, West Avenue next to the post office):

  • Electrical work inside the FPL vault

  • Mobilizing for site work, base preparation and layout

  • 17 Street generator conduit installation

  • Pending generator delivery (17 Street and West Ave)

Segment 2 (West Avenue between the post office and just south of Lincoln Road; Lincoln Road between Alton Road and the bay; and the Bay Road and Lincoln Court street ends):

  • Sanitary sewer testing (Lincoln Court, north of Lincoln Road and Bay Road, north of Lincoln Road)

  • Water quality well construction (Lincoln Road, east of Bay Road)

Segment 3 (West Avenue from just south of Lincoln Road to 16 Street; and 16 Street between Alton Road and Bay Road):

  • Signal foundation installation (16 Street and West Avenue intersection)

  • Water quality well piping installation (16 Street, east of West Avenue)

  • Sanitary sewer installation (West Avenue, north of 16 Street, and 16 Street, east of West Avenue)

  • Sanitary sewer testing (16 Street, west of West Avenue)

Tree Removals
Tree removals throughout Segments 2 and 3 will continue as needed. As a reminder, the contractor previously tagged trees for removal in preparation for upcoming drainage installation work and harmonization efforts.

Project WhatsApp Channel
We’ve launched a West Avenue Project WhatsApp channel. This channel will be used to share project updates, provide notifications during utility-related emergencies and offer a quick, convenient way to stay connected as work continues. Here’s the link to join: https://whatsapp.com/channel/0029VbBWsehCMY09hpApLX3r

Safety Reminder
Your safety is our top priority. As work continues throughout the West Avenue Phase II Project, please don’t enter construction zones or move any signs, cones, or barricades. These safety measures are there to protect you and help keep the project moving smoothly. Staying informed will be key throughout the construction process, and our team remains committed to supporting the community every step of the way. Should you have any questions or need further information, please do not hesitate to reach out.

Contact
Should you have any questions regarding this project, please contact myself or my colleague, Heather Leslie at 305.905.5876 or via email at heather@hmlpublicoutreach.com.

Aurora Gonzalez
Community Outreach Specialist
HML Public Outreach

cell: (305) 904-3447  |  aurora@HMLPublicOutreach.com

Check out our newly relaunched website: www.hmlpublicoutreach.com!

Next
Next

ANNOUNCEMENTS: Next SoBe West Community Meeting/Commission Meeting Updates
